Project Report
| Aug 28, 2012
New Campus Ready for Excited Students
By Sohail Farooq | Manager, Construction
![Jabri School Building nearing completion]()

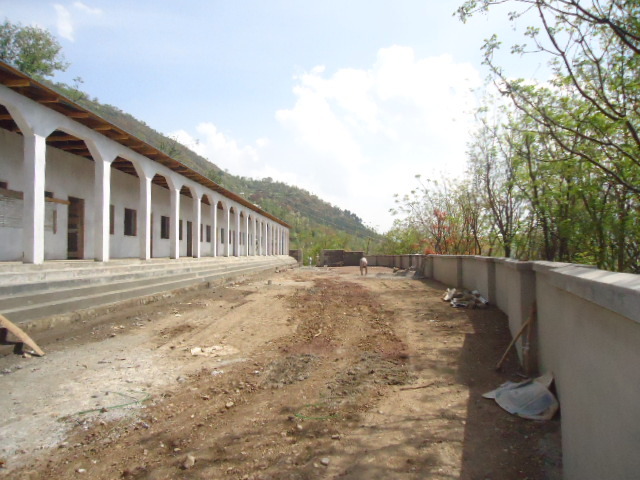

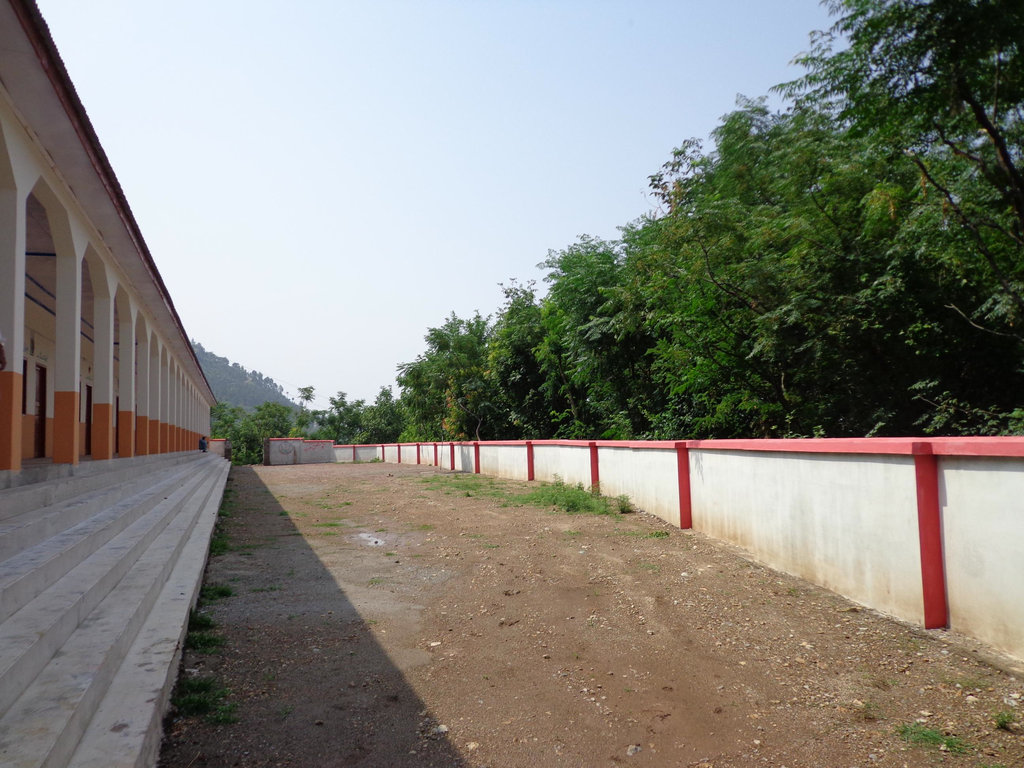

Jabri School Building nearing completion
Jabri School Construction Update: I visited the DIL School Jabri in Balakot on July 30th, 2012. Building work on the single story building is 98 percent completed. The main gate and glass window panes remain, while for the electric meter the demand notice has been submitted and will be installed within 15 days. Thus far, here is a list of completed works:
- Foundation work completed.
- School building blocks masonry work completed.
- CGI sheets & fall ceiling fitting completed.
- Playground leveling completed.
- Front and back retaining walls completed.
- Boundary wall completed.
- Water tank construction completed.
I have met with the parents of children in the Balakot. They are really happy and full of thanks to DIL Supporters for building a school in their village.
Ranjali School Construction Update: I visited DIL Ranjali school on Wednesday July 18, 2012. The Ranjali school is double story building which is under construction and roughly 60 percent of the work is complete. The ground floor plaster work and first floor brick masonry work will be completed in the next two weeks. Our estimated time for completion of this job is November, 2012. The work details are as follows:
- Building foundation work completed.
- Ground floor superstructure completed.
- Ground floor form work completed.
- Steel cutting and fixing completed.
- Ground floor concrete poring completed.
- Ground floor window protection completed.
- Ground floor plaster work started.
- Ground floor earth leveling & compaction started.
- First floor brick masonry work under process almost 40 percent completed.
- First floor window protection form works started.
- Boundary wall PPC & foundation completed.
- Boundary wall under construction 60 percent completed.
- Plinth protection under construction 30 percent completed.
- Septic tank demarcation completed.
- Septic tank construction completed.

![Ranjali School - Outside view]()
Ranjali School - Outside view

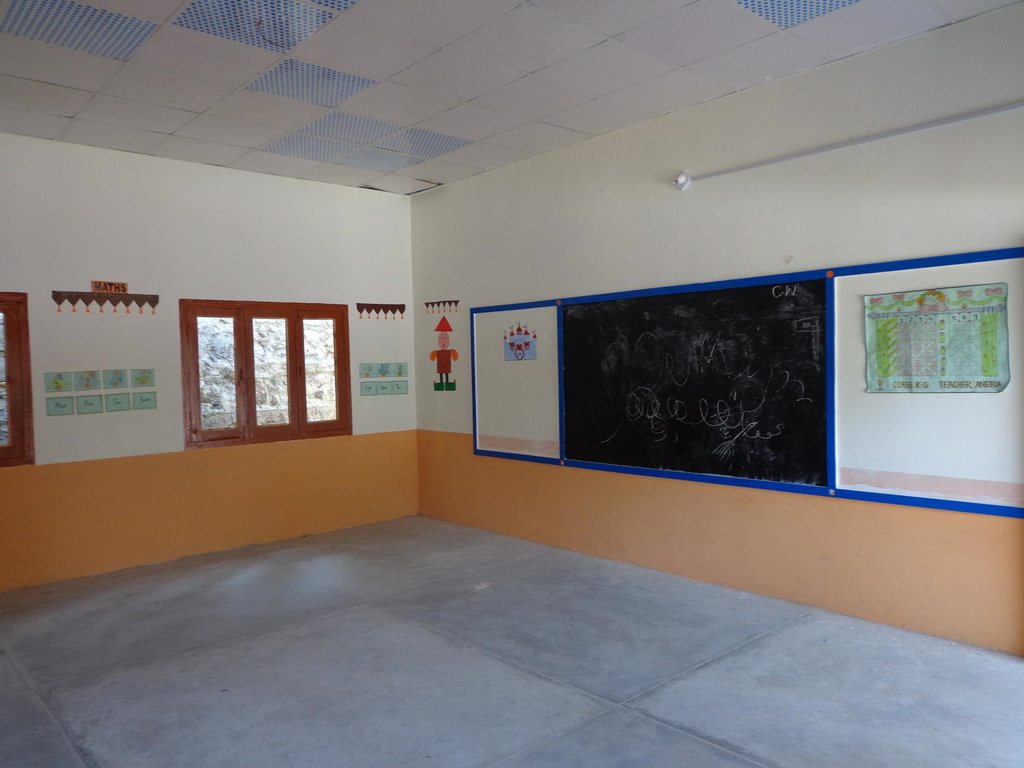

![Jabri School - Inside a classroom]()
Jabri School - Inside a classroom

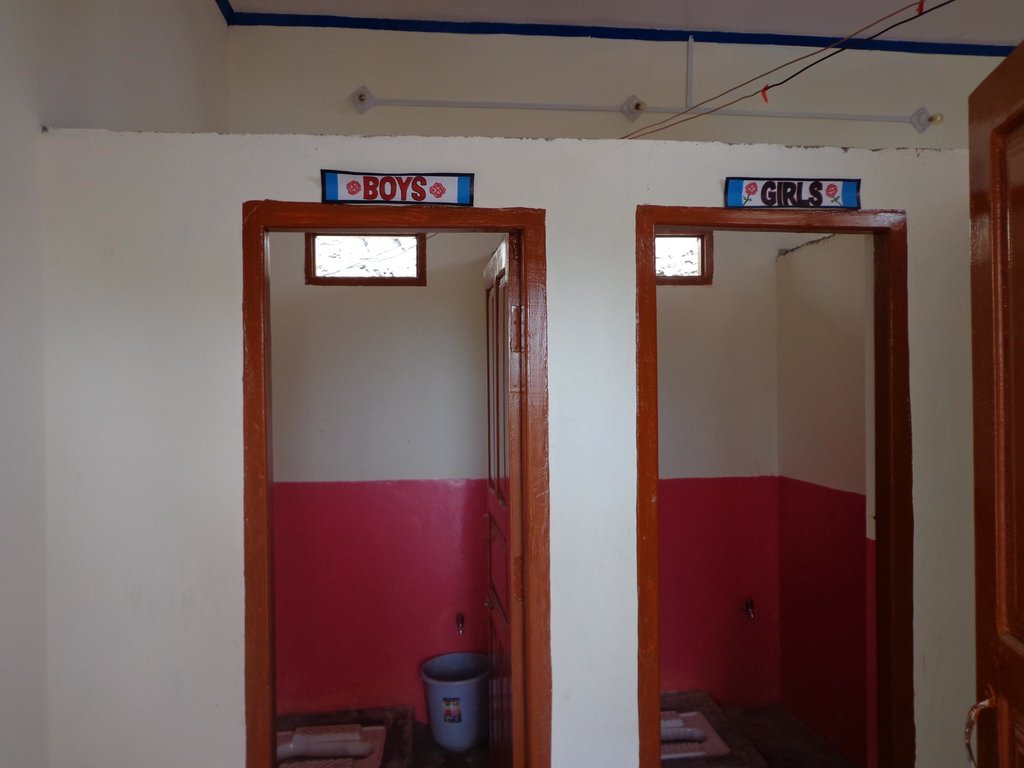

![Jabri School - Restrooms]()
Jabri School - Restrooms
May 31, 2012
New School Construction Near Completion
By Minerva Thai | Chapter Relations Manager, DIL-US

![Classroom ceiling]()
Classroom ceiling
This school is located in union council Shohal Mazullah and district Mansehra. This is single story building which is under construction. It is planned to have the following:
- (1) Playground with boundary wall
- (1) Principal's office
- (7) Classrooms
- (1) Computer lab
- (1) Library
- (3) Washrooms
85% of the construction work has now been completed with more and more being finished every day! As work is proceeding along quickly, the construction should be completed within the estimated time. Boundary wall plaster, roof & window protection, main gate work, bathroom & veranda insulation, stairs, drainage system installation, electricity fitting, and playground leveling are just some of the things that have been initiated and nearly completed. Here is an update on the process of each part of the construction:
- School building construction - 85 %
- Playground leveling - 90%
- Front & back retaining wall - 95%
- Building plaster work - 90%
- Door & window frames - 85%
- Boundary wall construction - 80%
- Classroom flooring - 100%
- Bathroom flooring - in process
- Bathroom partition walls - in process
- Water tanks - 50%
- Septic tank & soakage pit - 100%
- Sewerage line & drainage system - in process
- White base - 100% (ready for paint)
It has been exciting to see the progress of the school construction. The children can hardly wait to start at the new school. Please share this report/story to all that you know about what a difference these funds are making. We still have a ways to go so help the construction finish the last 15% of work!
![]()
![The team]()
The team
Links:
Apr 26, 2012
Hear from the students about DIL
By Laila Karamally | Executive Director
![A typical DIL Classroom]()
A typical DIL Classroom
"My name is Navid and I attend Class 7 at the DIL Communiy School in Jabri. I live in a very mountainous area. I used to go to a government school before, but the teachers there would never show up. Or if they did, it would be once a week and they would not teach me anything. Then I moved to the DIL Community School in Jabri. The teachers here are very nice. They give us activities to do. I return home at sundown - then I start my homework. Usually, I study by candlelight and make sure all my work is done. I wake up at sunrise and start the walk back to school. I want the new school to open soon!"
The DIL School Building project needs to raise $66,000. There are only FIVE days left to for the GlobalGiving Open Challenge campaign and DIL is currently in second place in terms of most funds raised. Help us secure the top spot and complete the DIL school in Jabri so that Navid and the hundreds more like those in the videos below can receive quality education.
